Bathroom Remodel Cost Calculator (2026)

Estimate a bathroom remodel by size, layout, fixture tier, tile square footage, and relocation scope. 2026 data; not a contractor bid.

By Martin Lashgari, Ph.D., P.E., PMP · Last reviewed June 2026

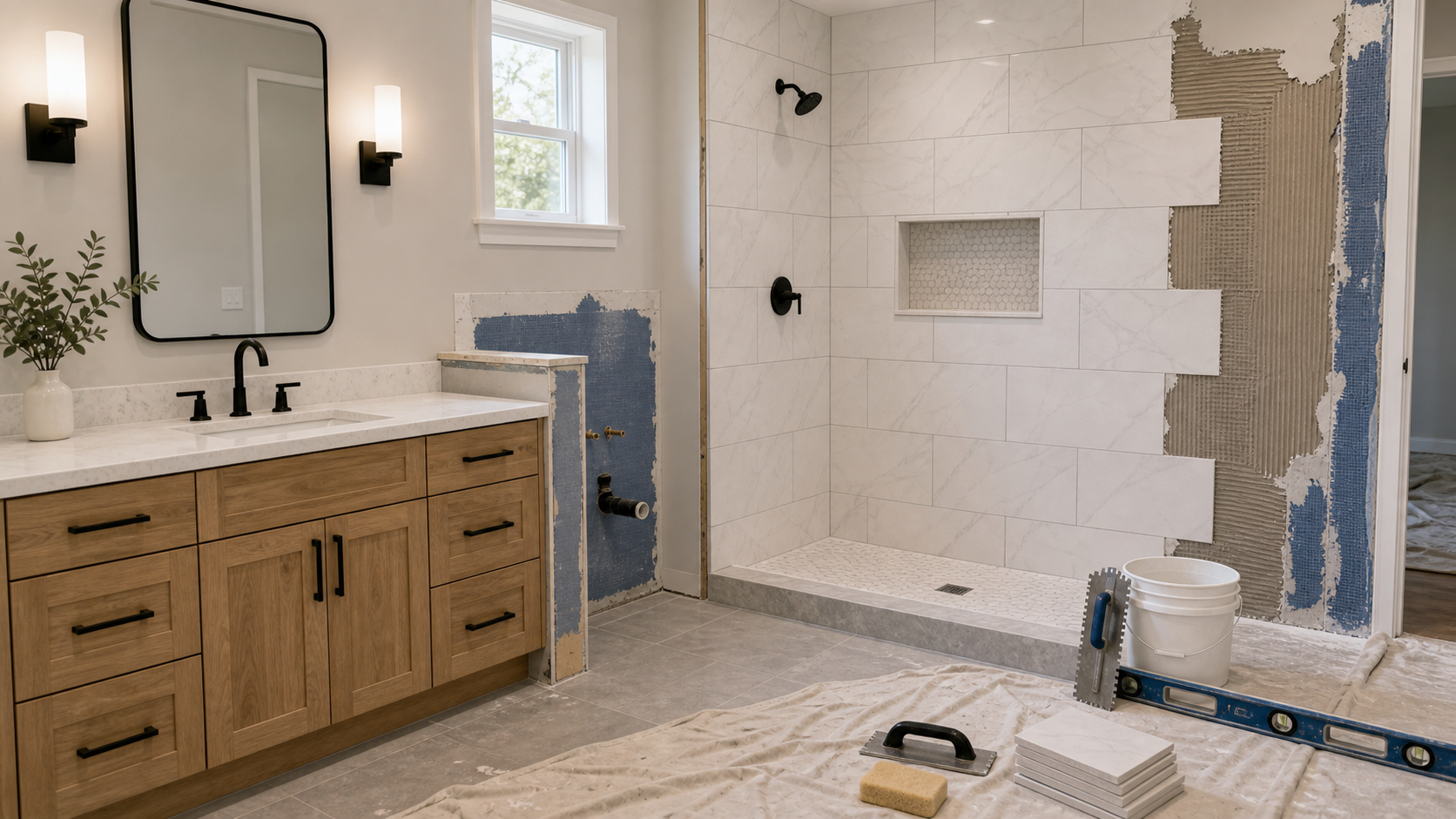

Modern bathroom mid-remodel with a freestanding soaker tub, tiled walk-in shower, double-vanity, and fresh hexagon tile flooring

Enter your bathroom project

Includes labor, equipment, permit, and contractor markup.

Common projects

Size & layout

Typical: powder 25, 3-piece 50, master 100+. Drives demo, paint, and floor tile scaling.
Uses the first 3 digits as a planning zone (not exact local pricing). Overrides state average when matched.

Fixtures

Footprint of custom tile shower. Standard 3x4 = 12 sf. Larger spa showers 20-30 sf.

Tile, glass & finishes

Trades & structural

Your bathroom estimate

Estimated installed range
Calculating…
Materials
$0
Labor
$0
Per sq ft
$0

Cost breakdown

ItemQuantityEstimated range
Planning estimate, not a bid. 2026 ranges informed by HomeGuide, HomeAdvisor, Homewyse, manufacturer (Kohler, Toto, Delta, Moen) MSRP, and BLS regional wage data.
What's not included: mold remediation, asbestos-flooring abatement, full HVAC ductwork addition, custom millwork beyond vanity, smart-mirror / radiant-towel-warmer integration, ongoing maintenance.

Bid check

Got a contractor quote? Compare it to the planning range.

Quote
$0
Range check
Scope risk
Add a quote amount to compare it against the current estimate.

Methodology & sources

What this is: a planning-range bathroom calculator informed by Kohler / Toto / Delta / Moen manufacturer pricing, HomeGuide, HomeAdvisor, Homewyse, and licensed cost-estimating references.

Size scaling: demo, paint, and floor-tile labor scale per square foot of bathroom area. Plumbing/electrical rough-in scale by layout type (powder/three-piece/master) and fixture relocation scope.

Labor is modeled from per-unit installed rates with a crew-rate sanity check ($75-$140/crew-hr loaded billing rate), informed by BLS OEWS 47-2152 (Plumbers / Pipefitters) and 47-2031 (Carpenters).

Last updated: May 2026. Full methodology →

Cost simulator Monte Carlo simulation See the full range of likely costs — with the odds

How much does a bathroom remodel cost in 2026?

ScopeRangeTimeline
Powder room refresh (25 sf)$4,000-$10,0003-5 days
Mid-range 3-piece (50 sf, no relocation)$12,000-$28,0002-3 weeks
3-piece + full layout change$18,000-$40,0003-5 weeks
Master spa bath (110 sf)$30,000-$80,000+4-8 weeks
Add-on: heated floor+$600-$1,200 (40 sf)included
Add-on: frameless glass shower+$1,000-$3,0001 week lead

Where your bathroom budget goes

In a mid-range 3-piece remodel, tile and tile labor take roughly a quarter of the budget, fixtures (tub, shower, toilet, vanity) another quarter to a third, and plumbing plus electrical labor about a quarter — with demo, paint, the exhaust fan, and the permit splitting the rest. Tile is the swing item: wall and shower tile run $20–$35 per sq ft installed and floor tile $16–$28.

ScopeRangeWhat moves it
Powder-room refresh$4,000 – $10,000New vanity, toilet, floor, paint — no wet work
Mid-range 3-piece$12,000 – $28,000Tub/shower, tile, vanity — same layout
Full layout change$18,000 – $40,000Fixtures relocated, new rough-in, often a building permit
Master spa bath$30,000 – $80,000+Double vanity, separate soaking tub + tile shower, heated floor

Tub, shower, or both?

The wet-area decision sets both the budget and the resale story:

  • Keep an acrylic tub ($706–$1,200 plus install) — the cheapest path, family-friendly, and the safe resale choice if it's the home's only full bath.
  • Tub-to-shower conversion — drop in an acrylic shower kit ($1,176–$2,000) for the budget route, or build a custom tile shower ($118–$200 per sq ft of footprint) with a frameless glass enclosure ($1,470–$2,500) for the spa version.
  • Soaking tub plus separate shower — master-bath territory; a cast-iron or deep soaking tub runs $2,059–$3,500 and you need the floor space and budget for both fixtures.

One resale caution: removing the only bathtub in the house to build a walk-in shower can hurt resale with families. If you have more than one bath, convert the secondary one and keep a tub somewhere.

The hidden cost: waterproofing and what's behind the wall

The tile you see is half a shower; the waterproofing you don't see is what keeps the wall from rotting. Modern code requires a continuous waterproof membrane behind wall tile — the old "tile over green drywall" approach fails inspection now, so a proper installation costs more than a quick one and is worth every dollar.

Other behind-the-wall surprises that move a bid: rotted subfloor under an old leaking tub, an undersized or missing exhaust fan (code wants ventilation to keep mold out), and relocating a vent stack when fixtures move. None of these show in a glossy before-and-after, but all of them show up on the invoice.

Frequently asked questions

How much does a bathroom remodel cost in 2026?

Powder room refresh: $4,000-$10,000. Mid-range 3-piece full bath (50 sq ft): $12,000-$28,000. Master spa bath (100+ sq ft, double vanity, separate tub + shower): $30,000-$80,000+. Full layout change with fixture relocation adds 25-60% to plumbing/electrical labor.

What bathroom size should I budget for?

Powder rooms run 18-30 sq ft, standard 3-piece full baths 40-60 sq ft, and master baths 80-150+ sq ft. Demo, paint, and floor tile scale linearly with that area. Plumbing rough-in is more about layout (powder vs full vs master) and whether fixtures move.

How does fixture relocation affect cost?

Reusing existing rough-in (no relocation) is the cheapest. Relocating one fixture within 4-6 ft adds about 25% to plumbing labor. A full layout flip — multiple fixtures moved or the bath rotated — adds 60% or more, plus likely floor framing modifications and a building permit instead of a plumbing permit.

Effect of relocation?

None = baseline. Minor +25%. Full flip +60%, plus floor framing mods + building permit.

DIY vs pro?

Demo, paint, vanity install — DIY-friendly. Plumbing + electrical require licensed pros + permit in most jurisdictions.

How long?

Powder 3-5 days. Mid-range 2-3 weeks. Master spa 4-8 weeks. Add 1-2 weeks if structural mods.

How much does a small bathroom remodel cost?

A standard 3-piece full bath (40-60 sq ft) kept in the same layout runs $12,000-$28,000. A powder-room refresh - vanity, toilet, floor, and paint with no wet work - is $4,000-$10,000.

How much does it cost to convert a tub to a shower?

Typically $3,000-$12,000. A drop-in acrylic shower kit ($1,176-$2,000 plus install) is the budget route; a custom tile shower runs $118-$200 per sq ft of footprint plus a frameless glass enclosure at $1,470-$2,500.

What is the most expensive part of a bathroom remodel?

Tile work and fixtures usually tie for the lead. Custom tile showers run $118-$200 per sq ft of footprint installed, and relocating plumbing fixtures adds 25-60% to labor versus reusing the existing rough-in.

Common mistakes & questions

  • Skip the curb height check — code requires 2 in min curb on tile showers.
  • Wall tile applied before waterproofing — fails inspection in modern code.
  • Heated floor under tub or vanity — wasted $$. Mat only under walking floor.
  • Skip exhaust fan or undersized — humidity rots drywall + framing.
  • Glass shower without proper drainage — water tracks under glass to floor below.
  • Wrong vanity height for users — taller users prefer 36 in over 32 in.
  • Ask your contractor: waterproofing system spec (Schluter Kerdi, RedGard), framing reinforcement for grab bars, ventilation CFM, lead time on tile + glass.

When this estimate is wrong

  • Hidden water damage in subfloor / framing — adds $1-5k.
  • Asbestos vinyl flooring or vermiculite insulation — abatement adds $1-3k.
  • Steam shower or sauna additions — separate scope, $5-20k.
  • Custom millwork or built-in storage adds 30-100% on cabinetry budget.
  • Code triggers: GFCI, AFCI, vent stack, vent termination height.
  • HOA / condo plumbing-stack work needs board approval + plumbing engineering.
